and DDP piling (1,157 total) installed by Cajun. All of this resulted
 in  an  increase of more  than  700 percent of  the original  contract
 value for Cajun.
 In addition, once the underground piping operations began,
 it became apparent that the soils were not conducive for open
 cut excavation installation. Cajun became involved and began
 installation of temporary sheet pile shoring to accommodate the
 piping and culvert installations. Cajun worked with the Owner to
 purchase nearly 113,000 square feet of PZC18 sheet piling. Cajun
 implemented  design  and  installation of  temporary and  permanent
 shoring in excess of 58 separate sumps and trenches utilizing
 these piling. These sheets were installed and extracted numerous
 times in a leapfrog fashion to accommodate the underground
 installations, resulting in a total installed quantity of 2.4 million
 square feet.
 As much of this work was being performed simultaneously, as
 many as 27 different cranes were utilized at one time to accomplish
 the  installations  in a  timely manner. This  required many
 crane moves and coordination with multiple contractors. Cajun
 worked closely with all parties to accomplish these moves with
 minimal impact to either the Owner, other contractors, the public
 or construction schedule. Weekly meetings were held between
 Cajun, FTI and the Owner to discuss crane schedules and moves,
 and how they coordinated with design drawing releases and work
 area preparations.
 Cajun utilized many different hammers to accomplish this
 work. For the pre-cast piling, diesel impact hammers were utilized,
 including: ICE I30; APE D30; and APE D36. For the sheet pile installations,
  vibratory hammers were utilized including: ICE 44B; APE
 200; APE 200-6; and APE King Kong at Pond 6. In order to complete
 sheet pile installation to grade at Pond 6, a BSP hydraulic impact
 hammer was also used. Spare hammers were kept and maintained
 onsite by a full-time Cajun mechanic to minimize downtime from
 equipment breakdowns.
 Dilution basin shoring
 The work at this project continued for Cajun until May 2018.
 During the course of the project, Cajun successfully performed
 this work with no serious incidents or recordable injuries. This
 was accomplished with a workforce of more than 300 employees
 at peak, many of whom were new to the piling trade and required
 on-the-job training. Also, during this nearly four-year period, many
 new and long-term employees were recognized for their performance
 and abilities and promoted to higher levels of responsibility
 within Cajun.  t
 PROJECT SPOTLIGHT
 As many as 27 different cranes
 were utilized at one time to
 accomplish the installations
 in a timely manner.

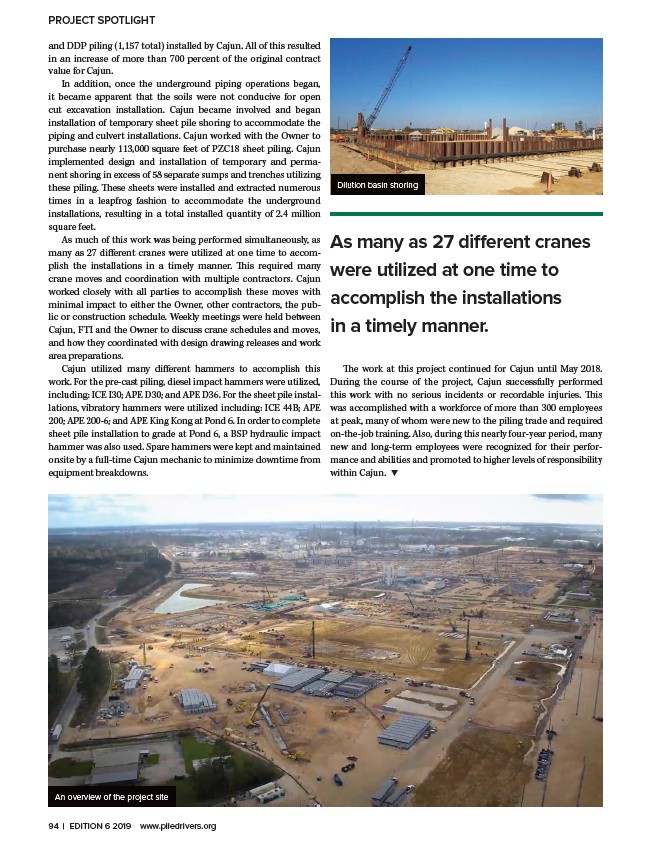

 An overview of the project site
 94  |  EDITION 6 2019  www.piledrivers.org
