allowed Chesterfield’s crews to work two shifts for most of the
 project, aiding in keeping as close as possible to a very tight
 construction schedule.
 Additional challenges resulted from needing to construct both
 sides of the pier sequentially due  to the fact that one side of the
 pier held up the opposing side with hot-dipped galvanized double
 channel wales and 2.5-inch high-strength threaded bars. The
 installation of the structural exterior wales and tie rods had to be
 coordinated around mid-tide and lower tide conditions due to Port
 Jef ferson tides that run six to seven feet in range. During some of
 the storms encountered during the construction period, the entire
 pier was submerged, putting a temporary halt to construction. The
 project crew experienced four “nor’easters” in the month of March
 2018 alone, and the winter of 2017-2018 was a very snowy season,
 as well. The existing pier structure(s) were up to 100 years old or
 more. We encountered varied existing construction, including
 steel, timber sheet piling and timber cribbing.
 Unfortunately, some of this old construction conflicted with the
 new construction, which occasionally necessitated dive crews to
 help move obstructions from the line of the new SSP bulkheading.
 PROJECT SPOTLIGHT

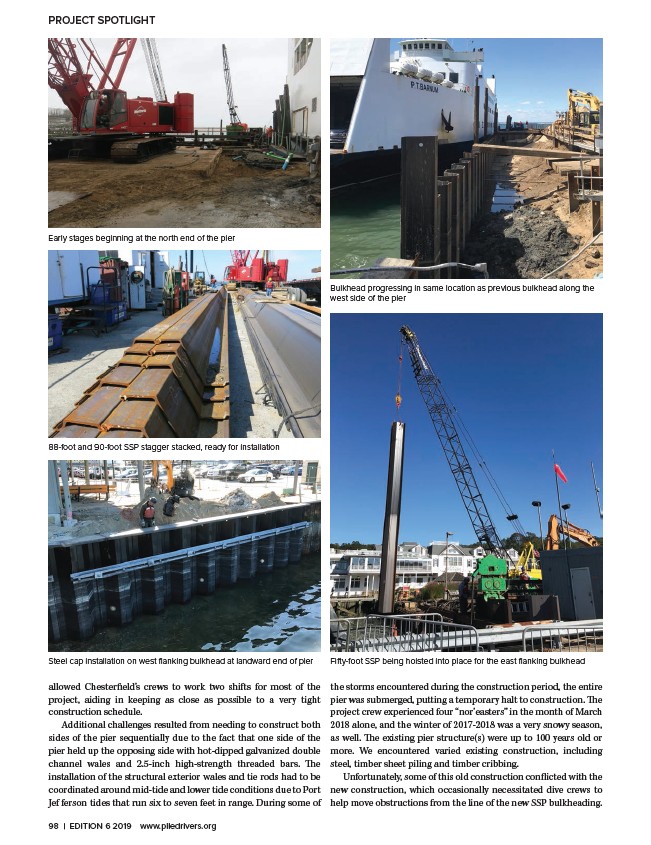

 Early stages beginning at the north end of the pier
 88-foot and 90-foot SSP stagger stacked, ready for installation
 Steel cap installation on west flanking bulkhead at landward end of pier
 Bulkhead progressing in same location as previous bulkhead along the
 west side of the pier
 Fifty-foot SSP being hoisted into place for the east flanking bulkhead
