PROJECT SPOTLIGHT
 As many as four trains would pass within a few feet of driven
 pile and sheeting locations on any given day. With no daily train
 schedule available, Boh Bros. would have limited advanced
 warning to move equipment safely out of the path of the trains.

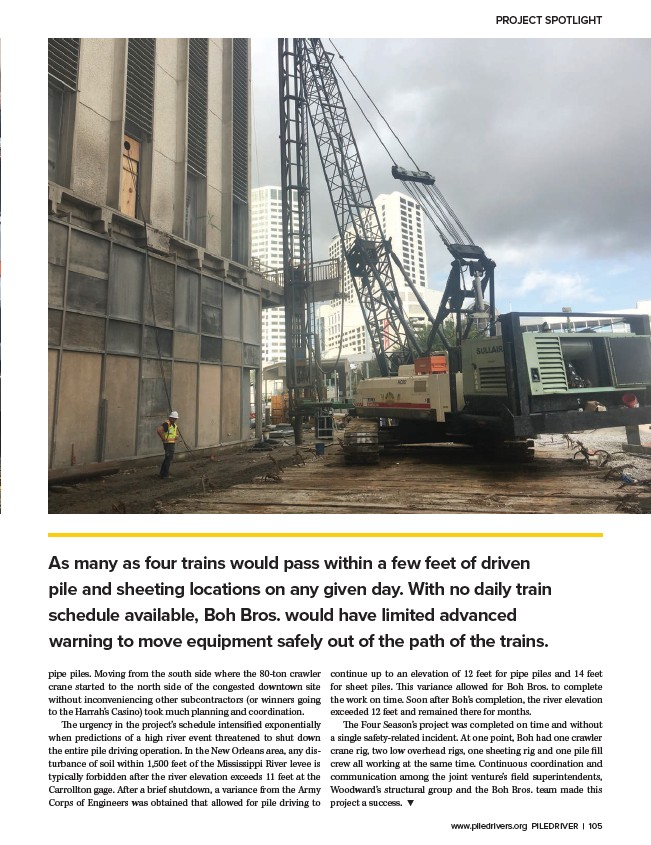

 pipe piles. Moving from the south side where the 80-ton crawler
 crane started to the north side of the congested downtown site
 without inconveniencing other subcontractors (or winners going
 to the Harrah’s Casino) took much planning and coordination.
 The urgency in the project’s schedule intensified exponentially
 when predictions of a high river event threatened to shut down
 the entire pile driving operation. In the New Orleans area, any disturbance
 of soil within 1,500 feet of the Mississippi River levee is
 typically forbidden after the river elevation exceeds 11 feet at the
 Carrollton gage. After a brief shutdown, a variance from the Army
 Corps of Engineers was obtained that allowed for pile driving to
 continue up to an elevation of 12 feet for pipe piles and 14 feet
 for sheet piles. This variance allowed for Boh Bros. to complete
 the work on time. Soon after Boh’s completion, the river elevation
 exceeded 12 feet and remained there for months.
 The Four Season’s project was completed on time and without
 a single safety-related incident. At one point, Boh had one crawler
 crane rig, two low overhead rigs, one sheeting rig and one pile fill
 crew all working at the same time. Continuous coordination and
 communication among the joint venture’s field superintendents,
 Woodward’s structural group and the Boh Bros. team made this
 project a success.  t
